What Happens When a PCB Component Is Out of Stock?

Direct answer: When a PCB component is out of stock, first verify the exact MPN, required quantity, need date, and approved source path. Then check an existing approved alternate. If none exists, engineering must evaluate any proposed substitute for electrical, package, thermal, timing, firmware, lifecycle, and compliance impact before purchasing. The remaining choices are usually to wait, buy under an approved exception, build partially, or redesign.

What decision does this guide support?

A shortage is not resolved by finding a part with a similar description. This decision flow helps engineering and purchasing preserve design intent while comparing schedule, commercial, and redesign exposure. Inventory information is time-sensitive, so every search result or quotation should be dated and tied to the exact orderable suffix and source.

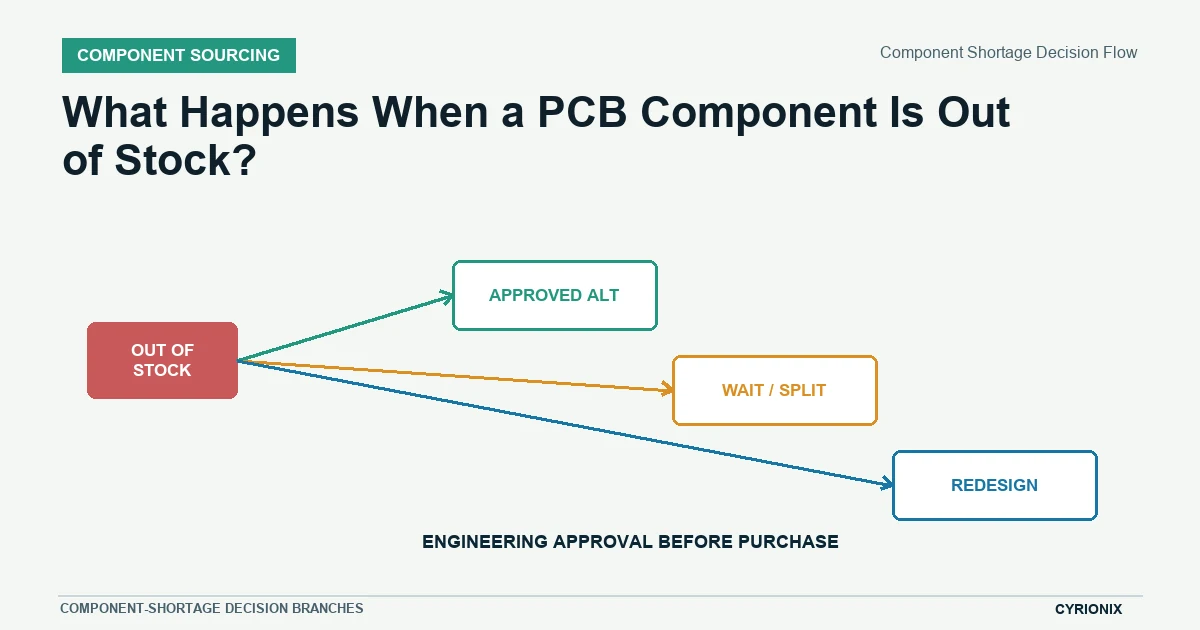

Component Shortage Decision Flow for component sourcing PCB assembly decisions
Shortage decision flow from stock confirmation through alternate review, commercial options, and controlled release.

Component shortage decision flow

Move through the stages in order. Each stage produces evidence for the next decision; skipping confirmation or approval can convert a supply problem into a functional or traceability failure.

StageRequired outputDo not advance when
ConfirmVerify exact part, quantity, need date, and shortage across approved channels.The shortage is based on a stale search or wrong suffix.
Existing alternateCheck whether an already approved alternate covers the affected design and revision.Approval applies to a different package or use case.
New substituteCompare electrical, package, thermal, timing, lifecycle, firmware, and compliance impact.Engineering review is incomplete.
Commercial optionCompare wait, allocation, excess buy, partial build, and redesign exposure.A broker purchase would violate source controls.
Prototype decisionUse a bounded deviation only when the learning objective remains valid.The temporary part changes the behavior being tested.
RecordUpdate approval, BOM, build revision, affected units, and future disposition.The next batch could repeat an expired exception.

Confirm that the shortage is real

Recheck the manufacturer part number, package, temperature or grade suffix, quantity, target date, and approved distributors. Distinguish zero stock from stock below the needed quantity, an extended factory lead time, an allocation, and a source restriction. Also verify whether usable customer-owned or previously purchased inventory exists.

Search within the approved supply path

Ask authorized distributors about regional inventory, inbound factory orders, minimum packs, scheduled releases, and valid cross-region transfer. Record the source, date, quantity, price, date-code information if relevant, and reservation terms. Search engines and marketplace listings are leads, not evidence that material is authentic, available, or acceptable.

Check existing approved alternates first

An alternate already approved for the same PCB revision, footprint, product variant, and operating conditions is usually the lowest-risk path. Confirm that the approval has not expired and that the exact alternate is itself available. Do not assume an alternate used on another product automatically covers this application.

Evaluate a new substitute systematically

Compare absolute ratings, operating conditions, function, pinout, package dimensions, land pattern, tolerances, thermal behavior, timing, interfaces, firmware or calibration effects, and lifecycle. Review product-specific safety, regulatory, customer, and traceability constraints. Capture datasheets and engineering rationale with the approval.

Compare wait, buy, partial build, and redesign

Waiting may preserve technical certainty but miss the market date. A higher-cost approved source or excess buy may protect schedule while increasing inventory exposure. A partial build can preserve learning only if the missing part does not invalidate assembly or test. Redesign has engineering, validation, documentation, and future-supply consequences that belong in the comparison.

Document the temporary or permanent decision

Update the BOM for a permanent change or issue a controlled deviation for a bounded build. Identify affected serials or lot, source, quantity, inspection needs, firmware or test changes, and disposition of unused material. Add an expiry or next-review condition so a prototype exception does not silently become the production standard.

A shortage response that preserves schedule evidence

  1. Open one exception record. Capture the exact shortage, need date, affected builds, and current approved state.
  2. Compare viable options. Put technical review, source evidence, cost, quantity, timing, and residual risk in one decision table.
  3. Release the chosen path. Record approval, purchasing instruction, affected revision, incoming checks, and future disposition.

Component shortage questions

Can a broker solve an urgent shortage?

A broker may identify supply, but source authenticity, traceability, storage history, inspection, testing, commercial recourse, and company policy must be evaluated. Urgency does not remove those controls.

Is the same base part number with a different suffix equivalent?

Not automatically. Suffixes can control package, reel format, temperature grade, qualification, finish, programming, or other attributes. Compare the manufacturer’s ordering information and the intended application.

When is a PCB redesign justified?

Consider redesign when the original part has poor lifecycle outlook, no defensible source or substitute, and the expected future demand outweighs revalidation cost and schedule. The decision should address the broader supply architecture rather than only the immediate order.

Related Cyrionix resources

Use the PCB component sourcing guide for source and alternate controls. Cyrionix component sourcing support can review shortages against a released BOM and build plan.
