Revision Control for Low-Volume PCB Assembly: Avoiding Mixed Builds
Direct answer: The practical answer to "How do we stop old files, BOMs, or substitutions from entering a new low-volume build?" is to use a documented decision gate, not a generic supplier promise. The target outcome is a release package, approval ownership model, and batch-to-revision traceability checklist. Start with the change request gate: Describe the reason, affected items, urgency, and requested effective batch. Then review the package and people who can approve exceptions. Hold the project when the change exists only in email fragments. Exact manufacturing, inspection, sourcing, and test scope depends on the selected design and partner. This guide makes scope explicit before quotation, release, or the next build decision.
What decision does this guide support?
Low-volume teams often release changes through email and spreadsheets, creating mixed-revision risk. This guide helps hardware engineers and operations leads managing repeat small batches make decisions about change and revision control. Its information gain is a six-gate revision release framework with stop conditions. The framework below is a project-control tool, not a claim that one process, supplier, quantity, or lead time fits every board.

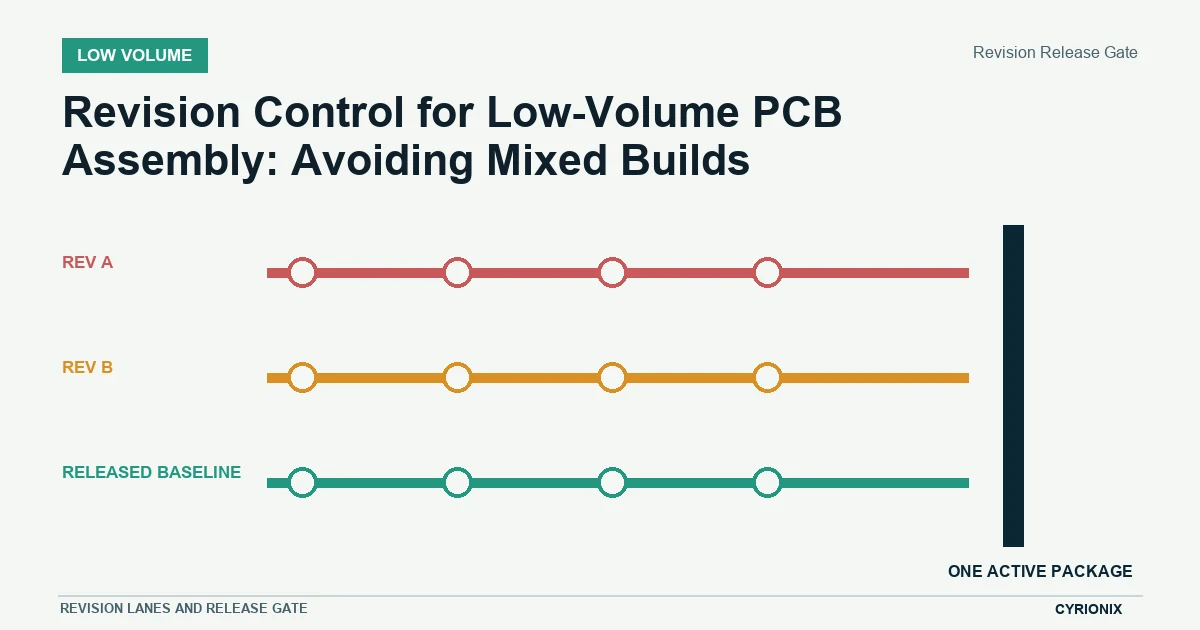

Revision Release Gate
Use this framework at the point where a project could otherwise move forward on an assumption. Each row names the evidence needed and a condition that should stop release until an owner resolves it.
| Checklist item | Required evidence | Hold condition |
|---|---|---|
| Change request | Describe the reason, affected items, urgency, and requested effective batch. | The change exists only in email fragments. |
| Impact review | Check PCB, BOM, CPL, drawings, firmware, test, packaging, and stock. | Any affected domain lacks an owner. |
| Material disposition | Decide use-as-is, rework, return, quarantine, or scrap for old stock. | Old and new material could enter the same batch. |
| Package release | Issue one dated baseline with superseded files removed from the active path. | Manufacturing can still access multiple approved-looking packages. |
| Acknowledgement | Require engineering, sourcing, manufacturing, and test to confirm the baseline. | A handoff party has not acknowledged the change. |
| Batch identity | Link purchase order, work record, firmware, test results, and labels to revision. | Finished units cannot be traced to the effective revision. |
Why revision control becomes harder in small batches
For the why revision control becomes harder in small batches step, use Change request as the control point. Describe the reason, affected items, urgency, and requested effective batch. Treat this as a release decision rather than an administrative detail. Place the build on hold when the change exists only in email fragments. Record the input reviewed, its revision or date, the decision owner, and the action required. That record keeps a later sourcing, assembly, test, or repeat-batch decision tied to the same baseline.
Define the manufacturing baseline
For the define the manufacturing baseline step, use Impact review as the control point. Check PCB, BOM, CPL, drawings, firmware, test, packaging, and stock. The useful evidence is a record another person can review without reconstructing the conversation. Place the build on hold when any affected domain lacks an owner. Record the input reviewed, its revision or date, the decision owner, and the action required. That record keeps a later sourcing, assembly, test, or repeat-batch decision tied to the same baseline.
The six release gates
For the the six release gates step, use Material disposition as the control point. Decide use-as-is, rework, return, quarantine, or scrap for old stock. This check should connect engineering intent to a purchasing or manufacturing action. Place the build on hold when old and new material could enter the same batch. Record the input reviewed, its revision or date, the decision owner, and the action required. That record keeps a later sourcing, assembly, test, or repeat-batch decision tied to the same baseline.
How to handle approved substitutions
For the how to handle approved substitutions step, use Package release as the control point. Issue one dated baseline with superseded files removed from the active path. A short written rule is more valuable than a broad assurance because it exposes the next owner. Place the build on hold when manufacturing can still access multiple approved-looking packages. Record the input reviewed, its revision or date, the decision owner, and the action required. That record keeps a later sourcing, assembly, test, or repeat-batch decision tied to the same baseline.
Batch records and feedback for the next revision
For the batch records and feedback for the next revision step, use Acknowledgement as the control point. Require engineering, sourcing, manufacturing, and test to confirm the baseline. The aim is not maximum paperwork; it is to prevent an unapproved assumption from entering the build. Place the build on hold when a handoff party has not acknowledged the change. Record the input reviewed, its revision or date, the decision owner, and the action required. That record keeps a later sourcing, assembly, test, or repeat-batch decision tied to the same baseline.
Revision-control checklist
For the revision-control checklist step, use Batch identity as the control point. Link purchase order, work record, firmware, test results, and labels to revision. Close the step with an explicit pass, hold, or approved-deviation result. Place the build on hold when finished units cannot be traced to the effective revision. Record the input reviewed, its revision or date, the decision owner, and the action required. That record keeps a later sourcing, assembly, test, or repeat-batch decision tied to the same baseline.
How to use the framework on a real project
- Define the baseline. Identify the board revision, assembly variant, quantity, intended learning or delivery outcome, and files being reviewed.
- Assign decisions. Name who can approve engineering changes, sourcing substitutions, process deviations, test failures, and schedule tradeoffs.
- Record the result. Store the pass, hold, or deviation outcome with the build package so a repeat order does not depend on memory.
Questions to close before release
What evidence is sufficient?
Evidence should match the risk. A file reconciliation may be enough for one decision; a datasheet comparison, inspection record, controlled test, or engineering approval may be needed for another. The key is that the evidence is named before work proceeds.
Who owns an exception?
The party executing purchasing or manufacturing can identify an issue and present options, but changes to functional intent require an authorized customer engineering decision. Put that boundary in the RFQ or release record.
When should the project stay on hold?
Hold when the next action would make an unresolved assumption expensive, irreversible, unsafe, or difficult to trace. A documented hold is usually less costly than discovering after assembly that teams used different revisions or acceptance criteria.
