Engineering decision guide

PCB Functional Test Fixture Requirements and Readiness Checklist

Release the hardware, firmware, sequence, limits and result rules needed to scope a repeatable functional test with an assembly partner.

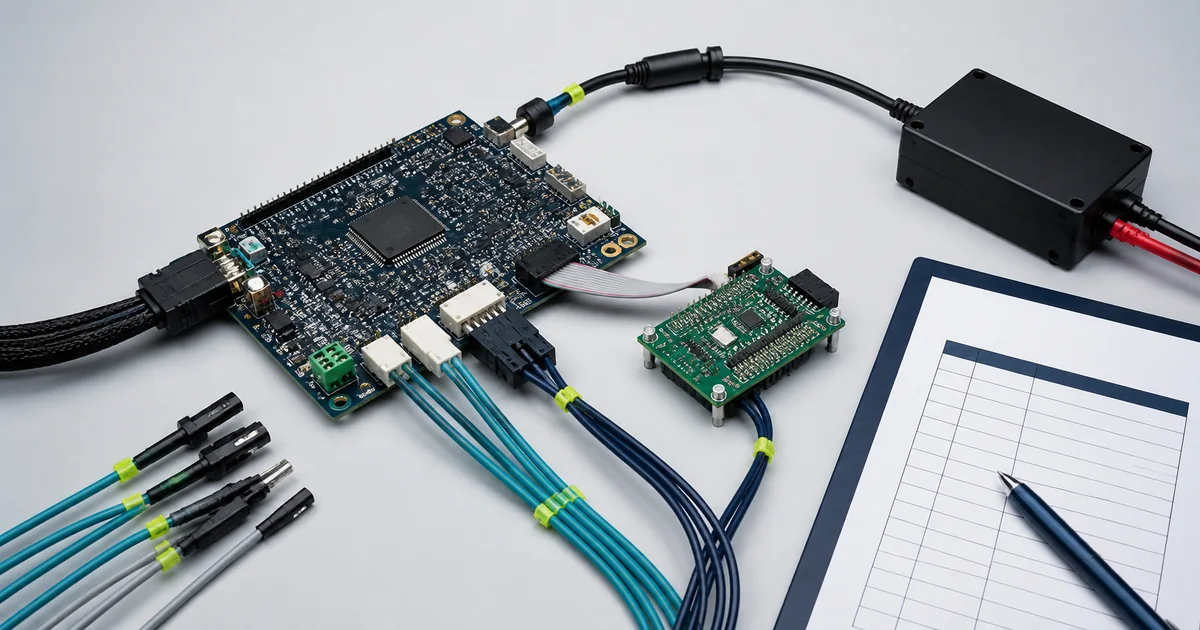

Populated PCB with orderly interface leads, power connection and reference board
Technical illustration of functional-test fixture requirements.
Direct answer

Define interfaces and safe power, fixture connections, controlled firmware, programming steps, test sequence, expected results, pass/fail limits, logging and failure disposition before asking a partner to perform functional testing.

A fixture is only one part of the test system

The fixture provides repeatable physical and electrical access. The product team must still define safe power, firmware, sequence, expected results, limits, data handling and failure disposition. A golden unit can support correlation but should not replace documented acceptance criteria.

Functional Test Readiness Checklist

InputWhat to releaseOwnerHold condition
Board identityAssembly number, revision, fitted variants and test configurationHardware / configuration ownerTest target is ambiguous
Interfaces and accessConnector/pad map, mating parts, pinout, keep-outs and mechanical accessHardware / test engineeringRequired signal or control is inaccessible
PowerNominal rails, current limit, sequencing, polarity and safe shutdownHardware engineeringUnsafe or undefined energization
Fixture conceptLocation/alignment, contact method, cable set, replaceable wear items and drawingsTest engineering with partnerRepeatable connection cannot be confirmed
Firmware / programmingControlled binary, version, checksum, tool/instructions, keys handling and verificationFirmware ownerImage identity or authorization is unresolved
Test sequenceOrdered setup, actions, stimuli, measurements and cleanupTest engineeringOperator must infer steps
Expected resultsUnits, nominal value, tolerance, timing window and allowed stateDesign ownerPass/fail cannot be calculated
Logging / serializationFields, serial source, file format, storage/retention and trace relationshipQuality / operationsResults cannot be associated with a unit
Reference unitKnown configuration, calibration/correlation purpose and custodyDesign / quality ownerGolden unit is undocumented or treated as sole criterion
Failure dispositionRetest limits, debug boundary, quarantine, evidence and escalation pathQuality / project ownerFailures can be repeatedly retested without control

From programming to recorded result

Control

Release one approved firmware image, instructions and identity evidence.

Connect

Use documented power, interfaces, fixture alignment and safe limits.

Execute

Run an ordered sequence with explicit stimuli, measurements and tolerances.

Record

Tie pass/fail, versions, values and exceptions to the correct unit and revision.

RFQ package questions

  • Is programming required, and who supplies tools, licenses or protected keys?
  • Does the request require continuity, functional behavior or both?
  • Who designs, owns, validates, stores and maintains the fixture?
  • What result files or labels must be returned with the batch?
  • What debug work is in scope after a failure, and who authorizes it?

Confirm capability per project

Functional testing ranges from a simple powered check to a software-controlled system with fixtures, instrumentation and traceability. Share the readiness package before expecting a partner to confirm feasibility, cost or schedule.

Confirm project-specific support.

The presence of this guide does not mean every programming method, interface, fixture or functional test is available through every Cyrionix partner.
